Final inspection is scheduled for Friday, August 22.
Cooper Mountain will be performing a final inspection of the roofs on Friday, August 22, beginning between 7:15 and 7:30 AM and lasting most of the day. You do not need to be home for the final inspection, but the roofing company will be walking on your roof. If you have tenants, please notify them.
Please walk around your home, look at your roof, flashing, etc., and note any issues. In addition, please submit any questions about your roof to the board at robinmedowshoa@gmail.com by the end of the day on Thursday.

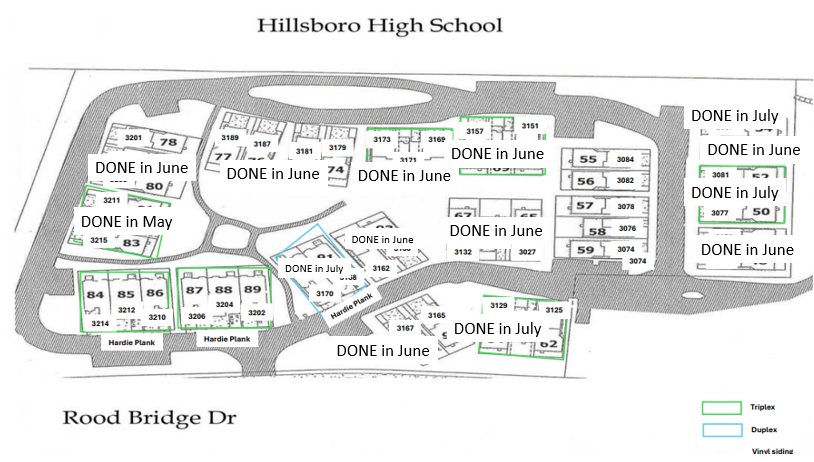

99% OF THE ROOFING PROJECT IS COMPLETE: To date, seven triplexes, one duplex, and 24 single-family homes have been completed. All 46 have been finished. A final walk-through will be scheduled, and the final bill will be paid which will conclude the project.
Please take a look at your home and note any issues with pictures and an e-mail to the board.
REPLACEMENT SCHEDULE: The following is the tentative order of roof replacement. Weather, crew availability, material delivery, and other factors may alter the schedule. Owners will be notified several days in advance of material delivery and/or work beginning on their home.
83% OF THE ROOFING PROJECT IS COMPLETE: To date, five triplexes, one duplex, and 21 single-family homes have been completed. 38 of 46 roofs (83%) have been finished. Please take a look at your home and note any issues with pictures and an e-mail to the board.

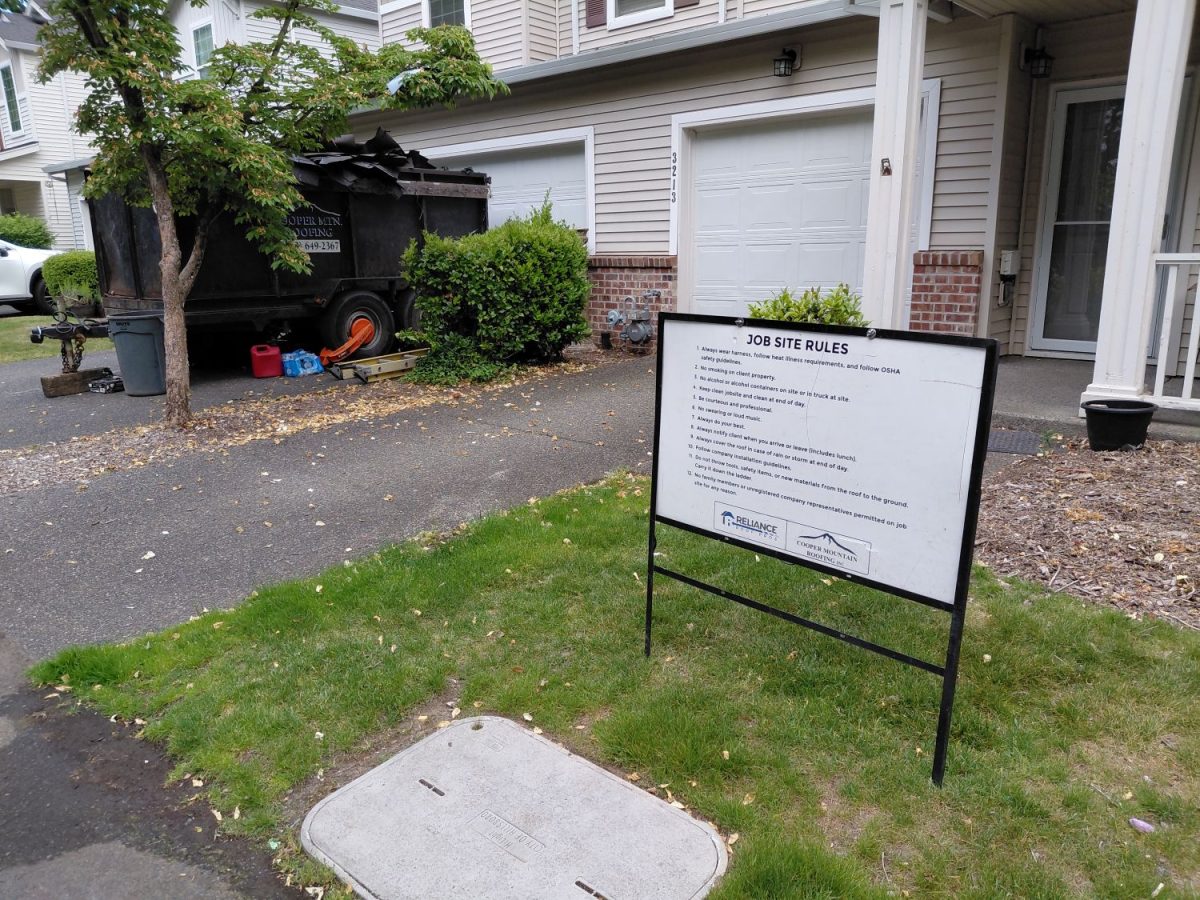

DRIVEWAY ACCESS: Cooper Mountain will need full access to your driveway while working on your roof. Please move all vehicles from your driveway to protect your vehicle and facilitate your roofing being replaced in a timely manner.

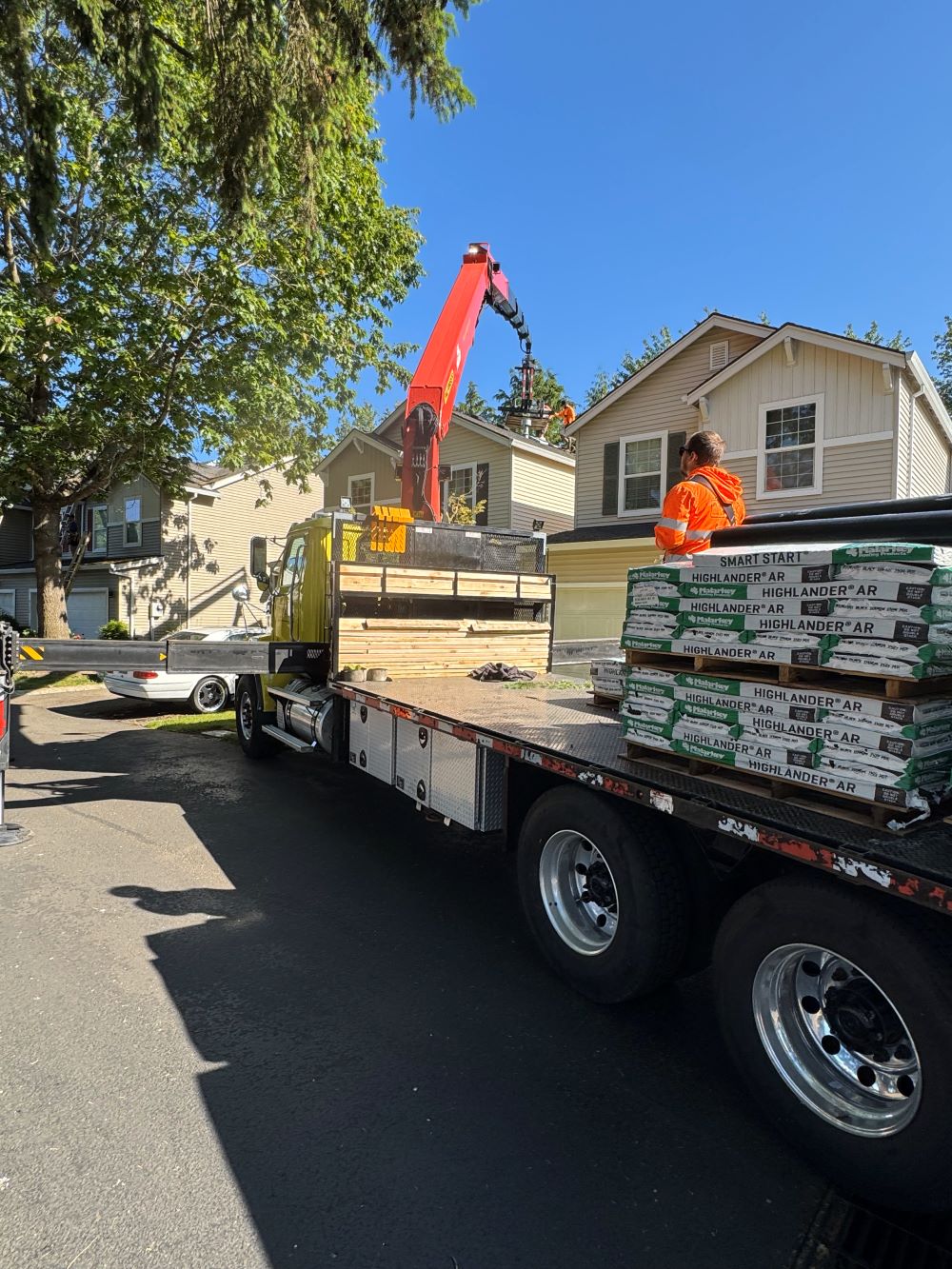

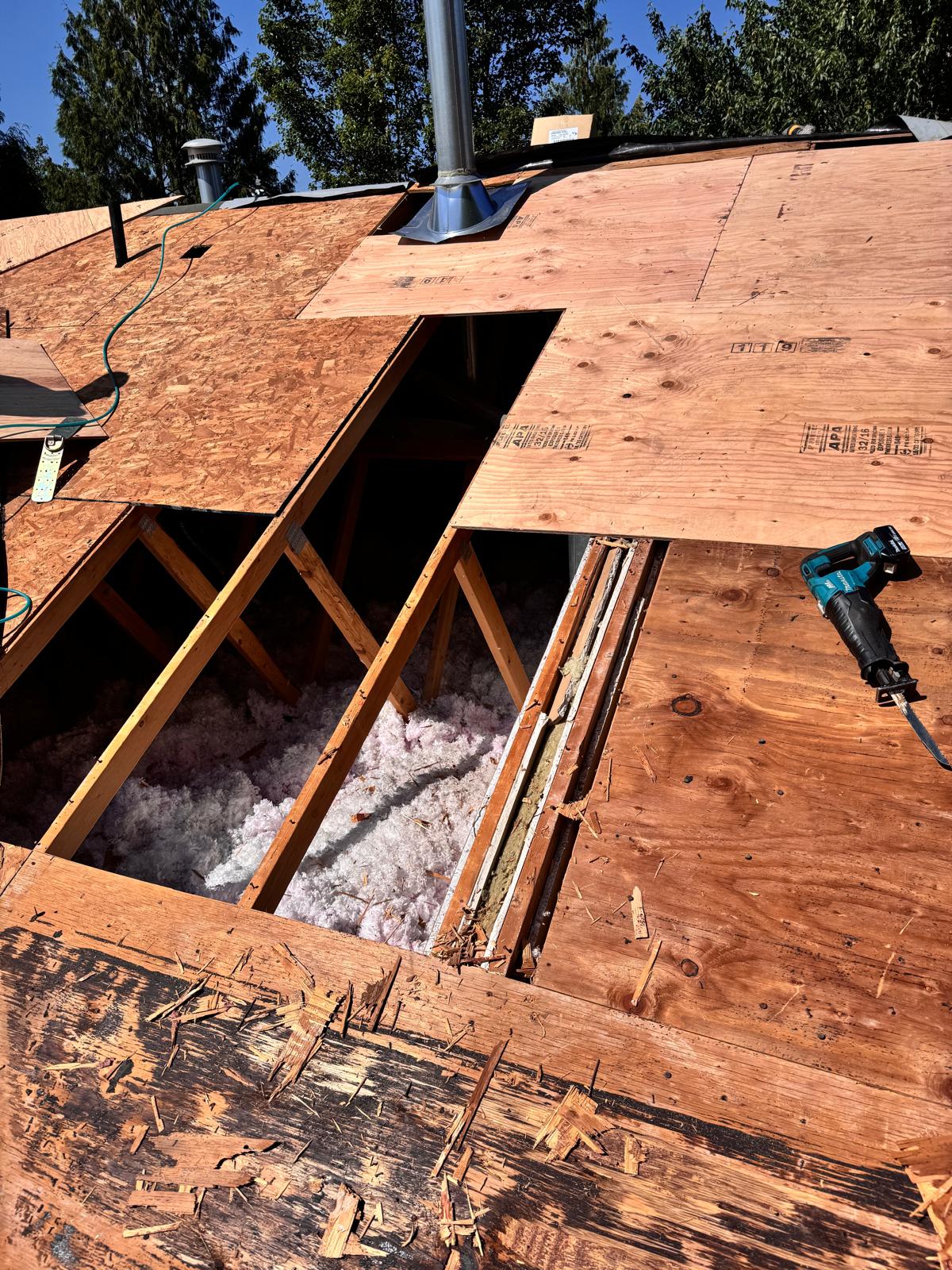

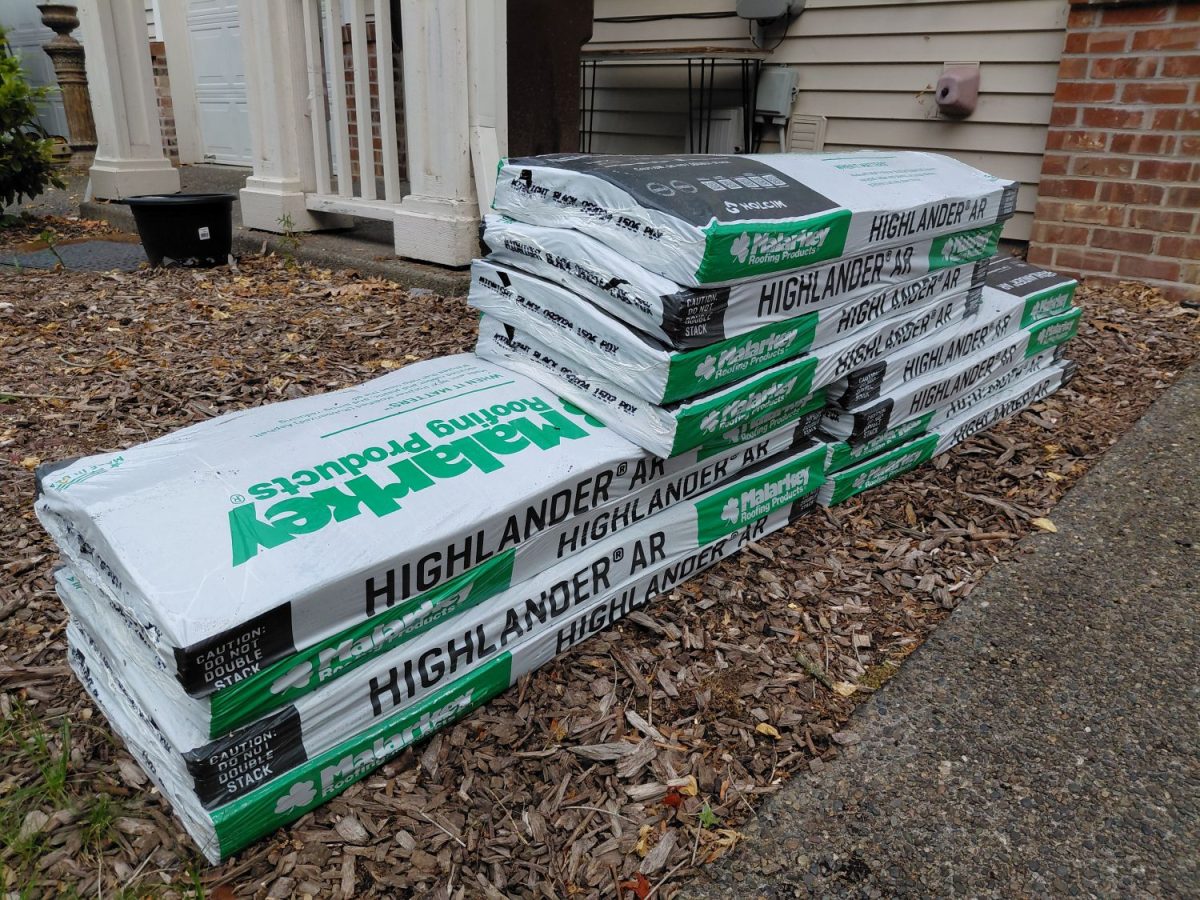

WEATHER: Remember that roofing is weather-dependent. Rain, extreme heat, or smoke from wildfires can delay the work.
REPLACEMENT SCHEDULE: The following is the tentative order of roof replacement. Weather, crew availability, material delivery, and other factors may alter the schedule. Owners will be notified several days in advance of material delivery and/or work beginning on their home.
ALMOST 80% OF THE ROOFING PROJECT IS COMPLETE: To date, five triplexes, one duplex, and 18 single-family homes have been completed. 35 of 46 roofs (76%) have been finished. Please take a look at your home and note any issues with pictures and an e-mail to the board.
CONTINGENCY BUDGET: Through the first 28 homes, we spent $24,900.19 on contingencies, which is $3,099.81 under budget. A third of the contingencies were from the 3169/3171/3173 ($4,943.62) and 3151/3153/3157 ($3,759.88) triplexes. Three other homes (3179: $1,934.82 | 3160: $1,927.81 | 3165: $2,914.47) were over budget on a per-home basis while the rest were under budget. These nine homes account for over 62% of the contingency spending.
DRIVEWAY ACCESS: Cooper Mountain will need full access to your driveway while working on your roof. Please move all vehicles from your driveway to protect your vehicle and facilitate your roofing being replaced in a timely manner.
WEATHER: Remember that roofing is weather-dependent. Rain, extreme heat, or smoke from wildfires can delay the work.
REPLACEMENT SCHEDULE: The following is the tentative order of roof replacement. Weather, crew availability, material delivery, and other factors may alter the schedule. Owners will be notified several days in advance of material delivery and/or work beginning on their home.

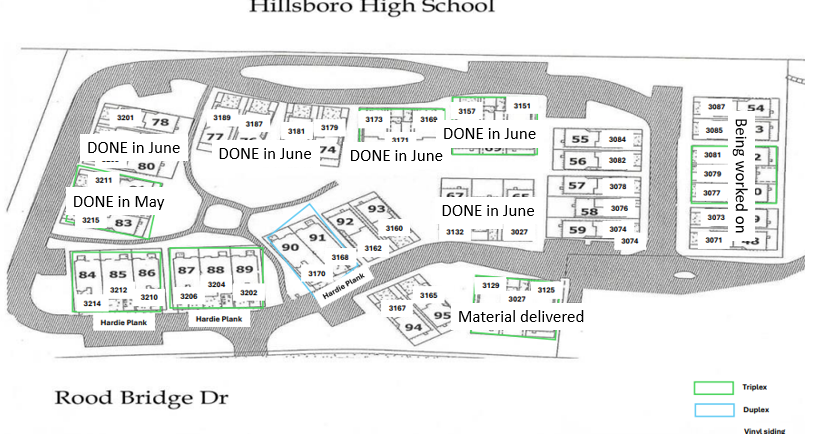

61% OF THE ROOFING PROJECT IS COMPLETE: To date, three triplexes, one duplex, and 17 single-family homes have been completed. 28 of 46 roofs (61%) have been finished. Please take a look at your home and note any issues with pictures and an e-mail to the board.
DRIVEWAY ACCESS: Cooper Mountain will need full access to your driveway while working on your roof. Please move all vehicles from your driveway to protect your vehicle and facilitate your roofing being replaced in a timely manner.
WEATHER: Remember that roofing is weather-dependent. Rain, extreme heat, or smoke from wildfires can delay the work.
REPLACEMENT SCHEDULE: The following is the tentative order of roof replacement. Weather, crew availability, material delivery, and other factors may alter the schedule. Owners will be notified several days beforehand of material delivery and/or work beginning on their home.
52% OF THE ROOFING PROJECT IS COMPLETE: To date, three triplexes and 15 single-family homes have been completed. 24 of 46 roofs (52%) have been finished. Please take a look at your home and note any issues with pictures and an e-mail to the board.
DRIVEWAY ACCESS: Cooper Mountain will need full access to your driveway while working on your roof. Please move all vehicles from your driveway to protect your vehicle and facilitate your roofing being replaced in a timely manner.
WEATHER: Remember that roofing is weather-dependent. Rain, extreme heat, or smoke from wildfires can delay the work.
REPLACEMENT SCHEDULE: The following is the tentative order of roof replacement. Weather, crew availability, material delivery, and other factors may alter the schedule. Owners will be notified several days before hand of material delivery and/or work beginning on their home.
41% OF THE ROOFING PROJECT IS COMPLETE: To date, three triplexes and 10 single-family homes have been completed. 19 of 46 roofs (41%) have been finished. Please take a look at your home and note any issues with pictures and an e-mail to the board.
CONTINGENCY BUDGET: Through the first 14 homes, we spent $10,279.24 on contingencies which is $3,721.76 under budget. Almost half of the contingencies were from the 3169/3171/3173 triplex ($4,943.62). Only one other home (3179) was over budget on a per-home basis ($1,934.82). These four homes accounted for over 67% of the contingency spending.
DRIVEWAY ACCESS: Cooper Mountain will need full access to your driveway while working on your roof. Please move all vehicles from your driveway to protect your vehicle and facilitate your roofing being replaced in a timely manner.
WEATHER: Remember that roofing is weather-dependent. Rain, extreme heat, or smoke from wildfires can delay the work.
REPLACEMENT SCHEDULE: The following is the tentative order of roof replacement. Weather, crew availability, material delivery, and other factors may alter the schedule. Owners will be notified several days before hand of material delivery and/or work beginning on their home.
35% OF THE ROOFING PROJECT IS COMPLETE: To date, three triplexes and seven single-family homes have been completed. 16 of 46 roofs (35%) have been finished. Please take a look at your home and note any issues with pictures and an e-mail to the board.
DRIVEWAY ACCESS: Cooper Mountain will need full access to your driveway while working on your roof. Please move all vehicles from your driveway to protect your vehicle and facilitate your roofing being replaced in a timely manner.
WEATHER: Remember that roofing is weather-dependent. Rain, extreme heat, or smoke from wildfires can delay the work.
REPLACEMENT SCHEDULE: The following is the tentative order of roof replacement. Weather, crew availability, material delivery, and other factors may alter the schedule. Owners will be notified several days before hand of material delivery and/or work beginning on their home.
